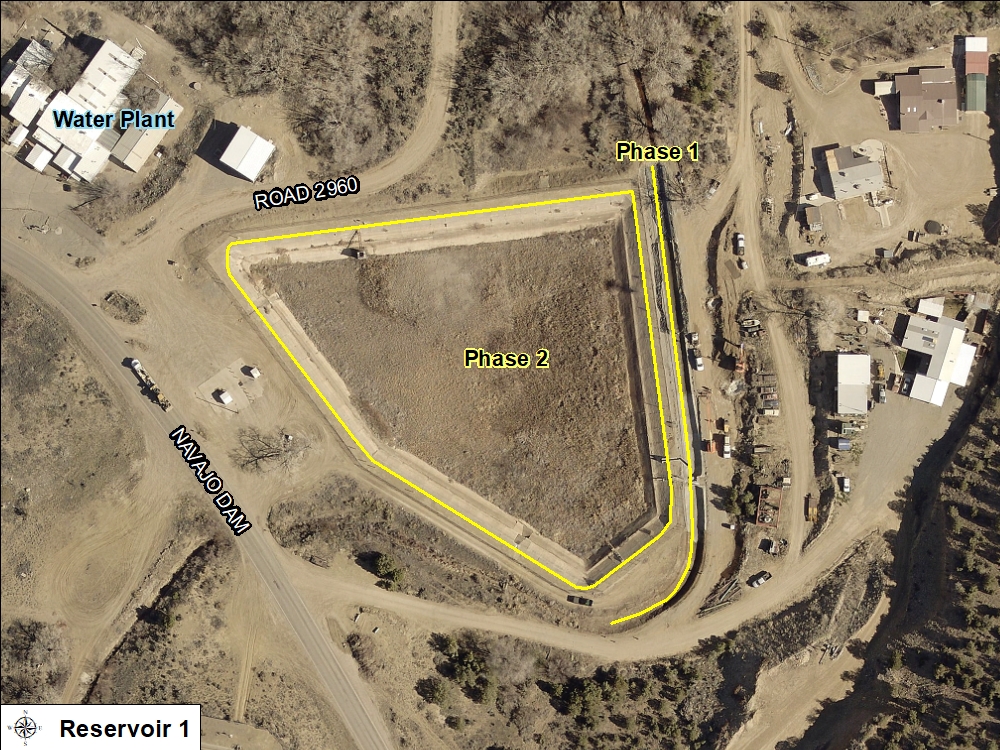

Phase 1
Phase 1 involved reconstruction and shot-concreting of the irrigation ditch lining along Reservoir #1. The irrigation lining was concreted, inlet reconstructed, and completed in 2023.
Phase 2
Phase 2 construction involves the concrete lining and tower rebuild within the reservoir.
1/23/2024 |
The project was awarded. |
2/20/2024 |

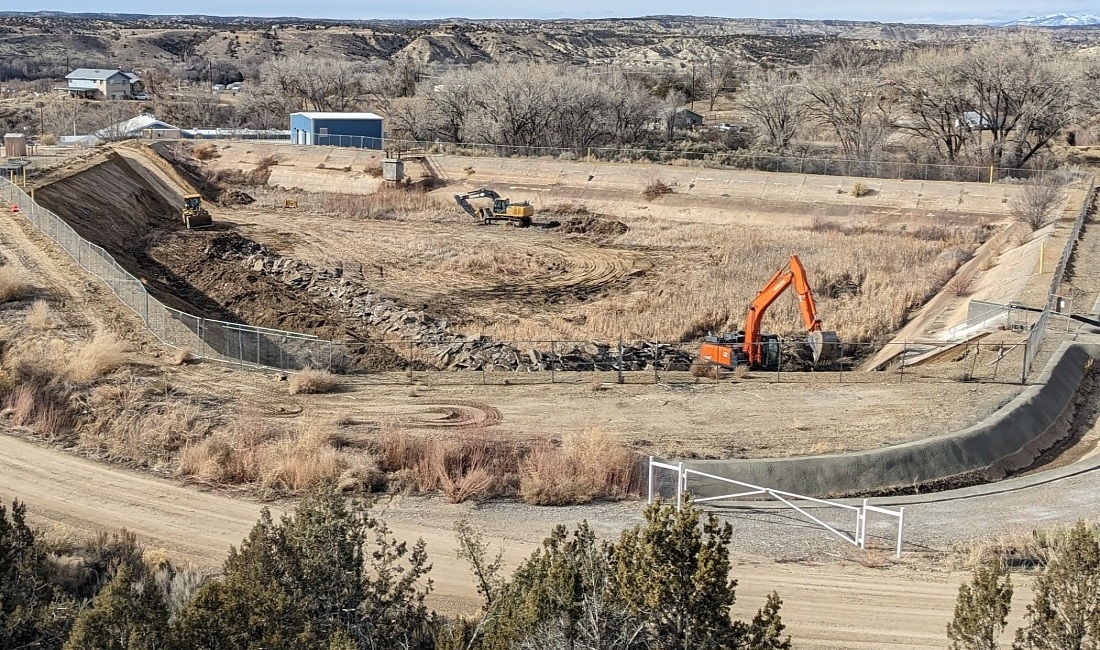

Demolition begun. |
2/28/2024 |

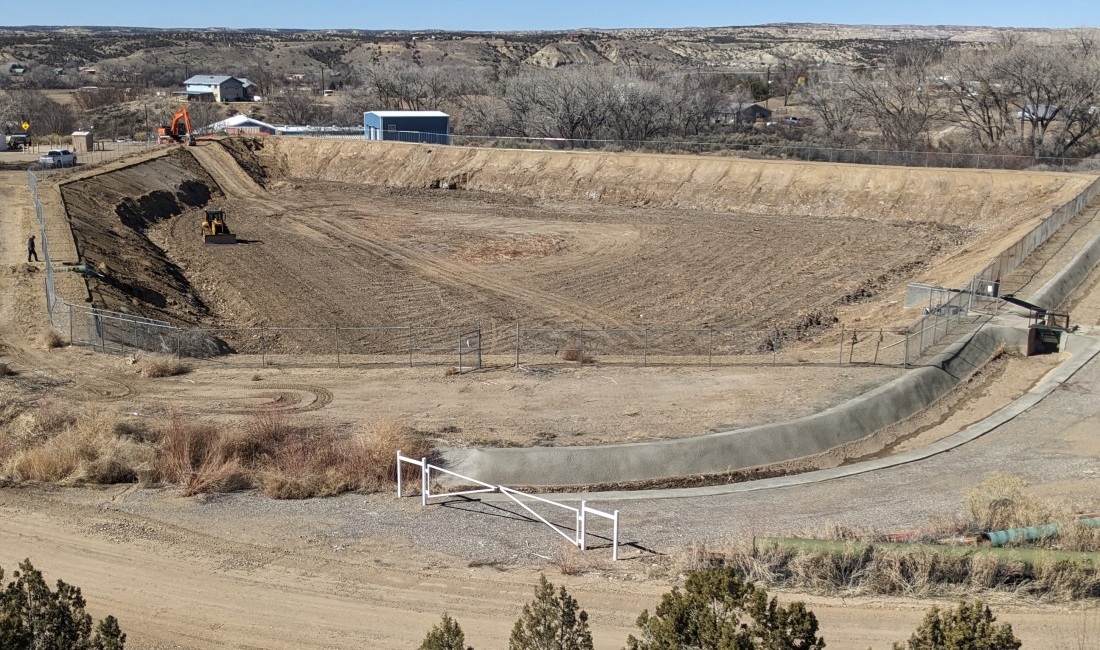

Demolition of concrete liner completed |

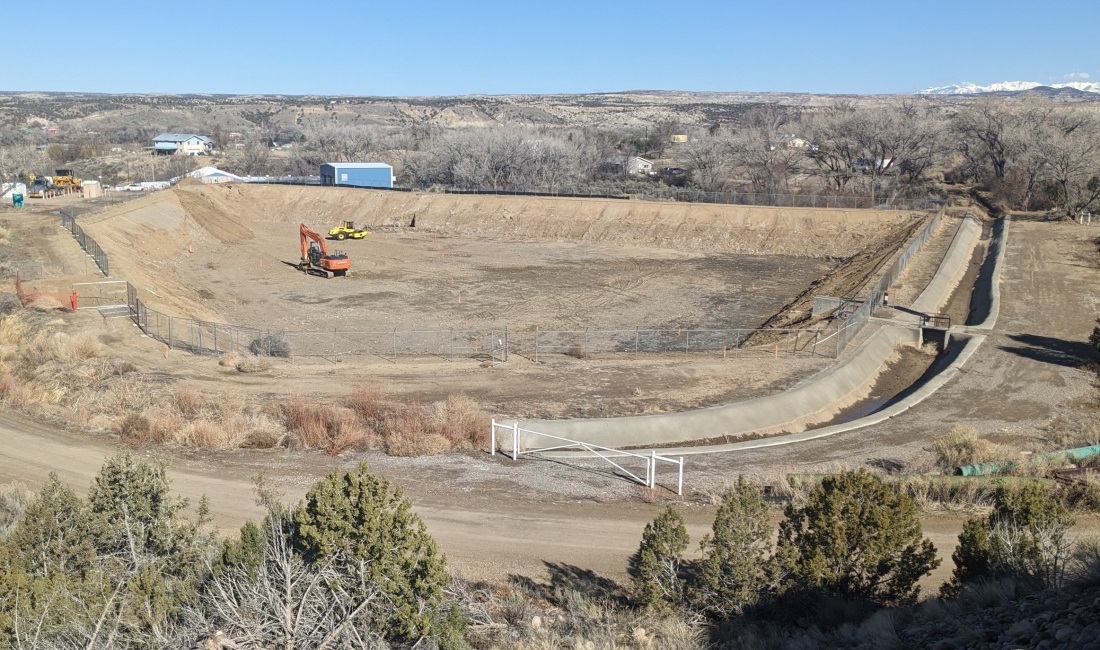

3/20/2024 |

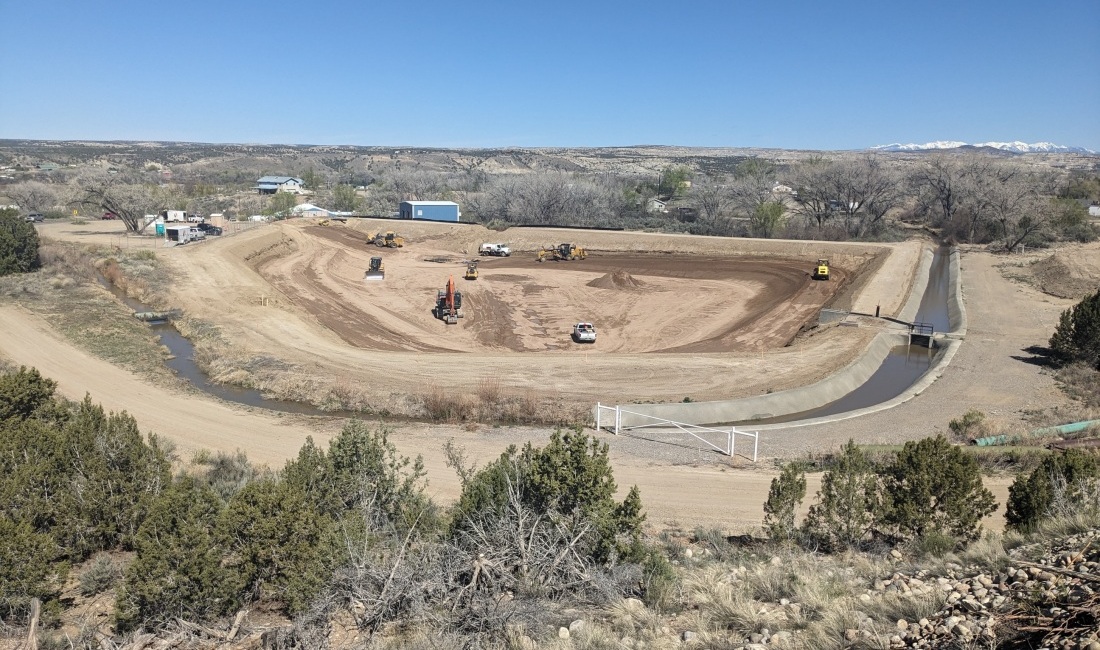

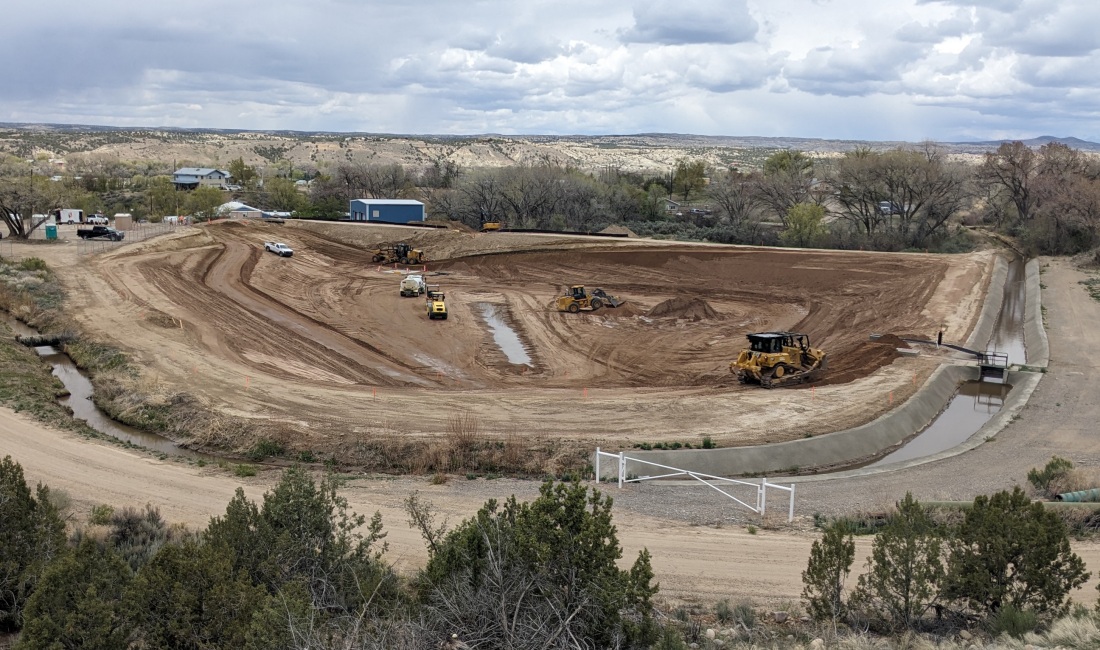

Dirt work, shaping, and elevation marking underway |

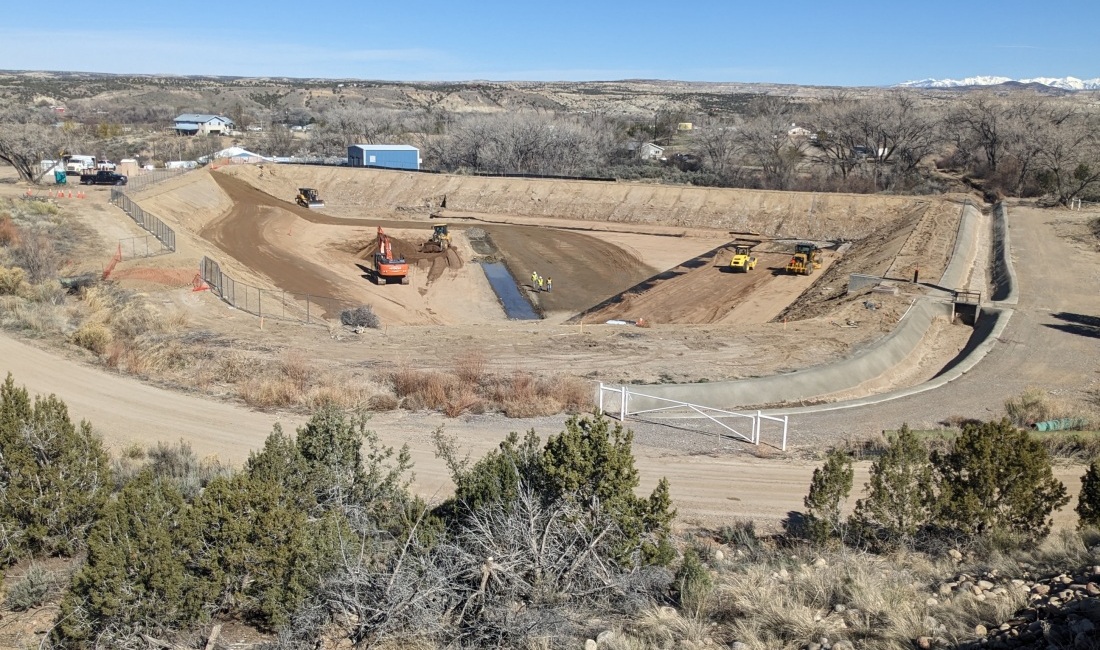

4/4/2024 |

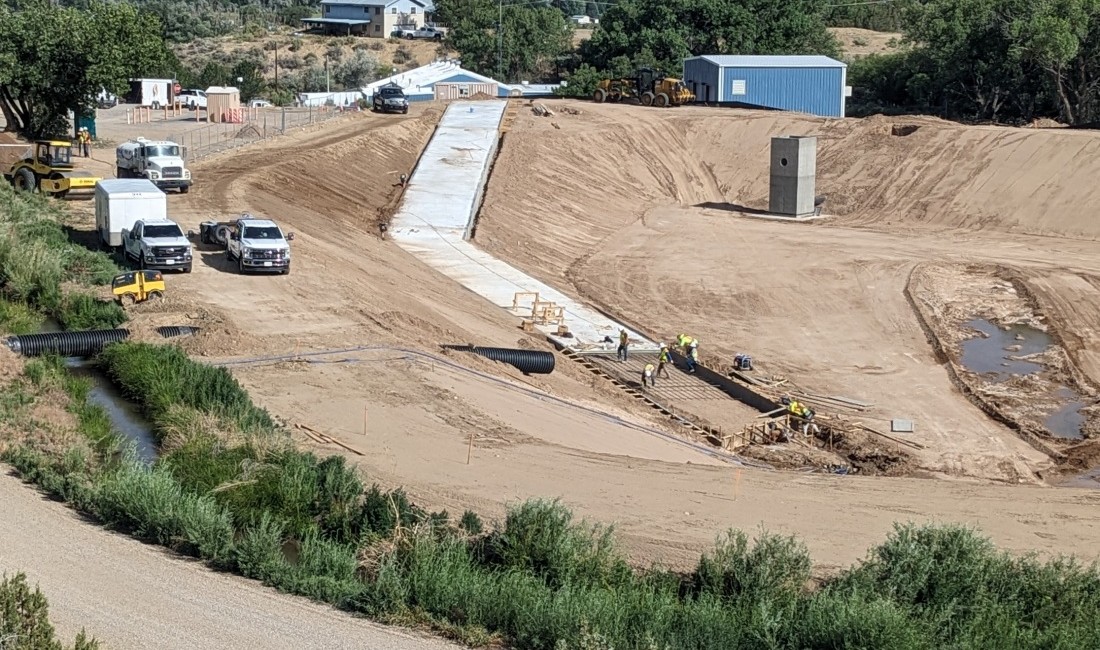

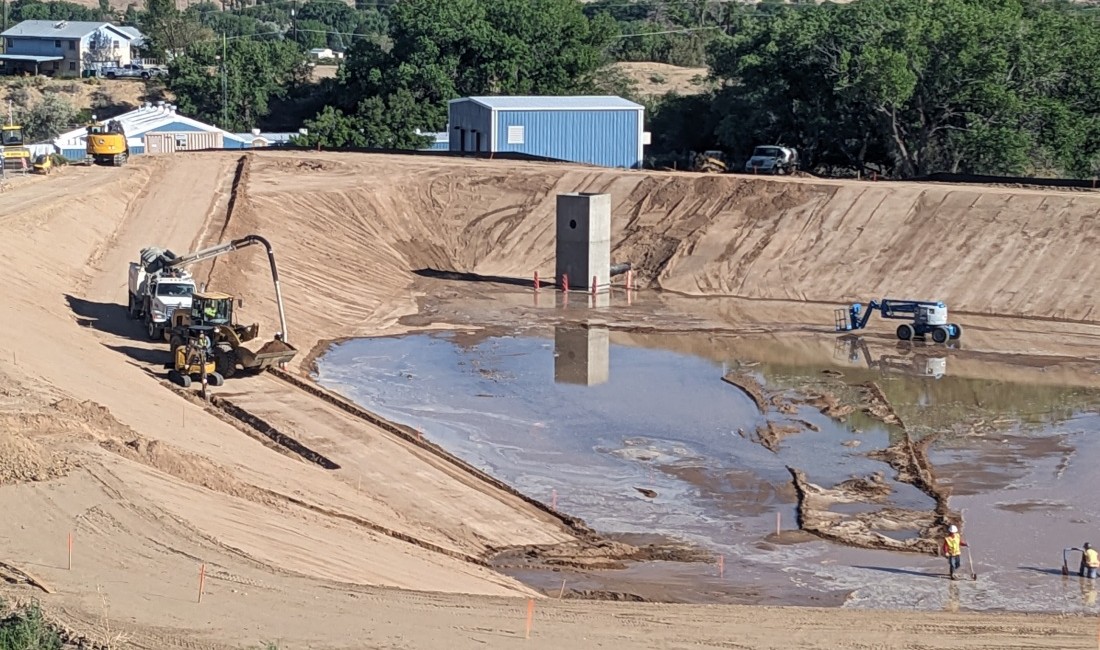

Lining and base prep underway. |

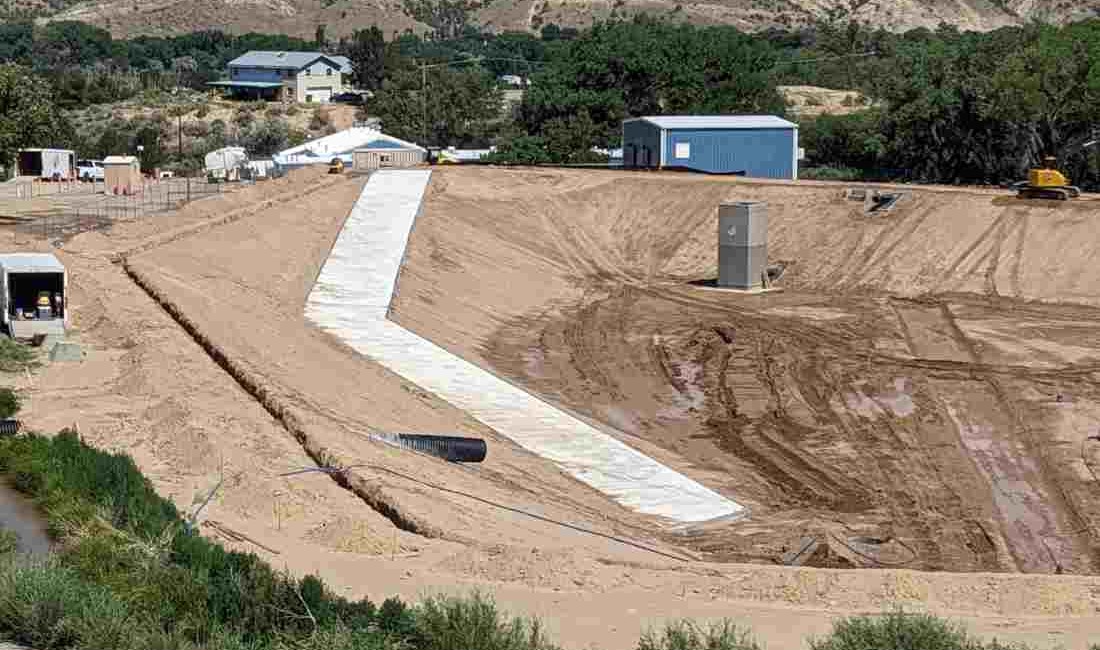

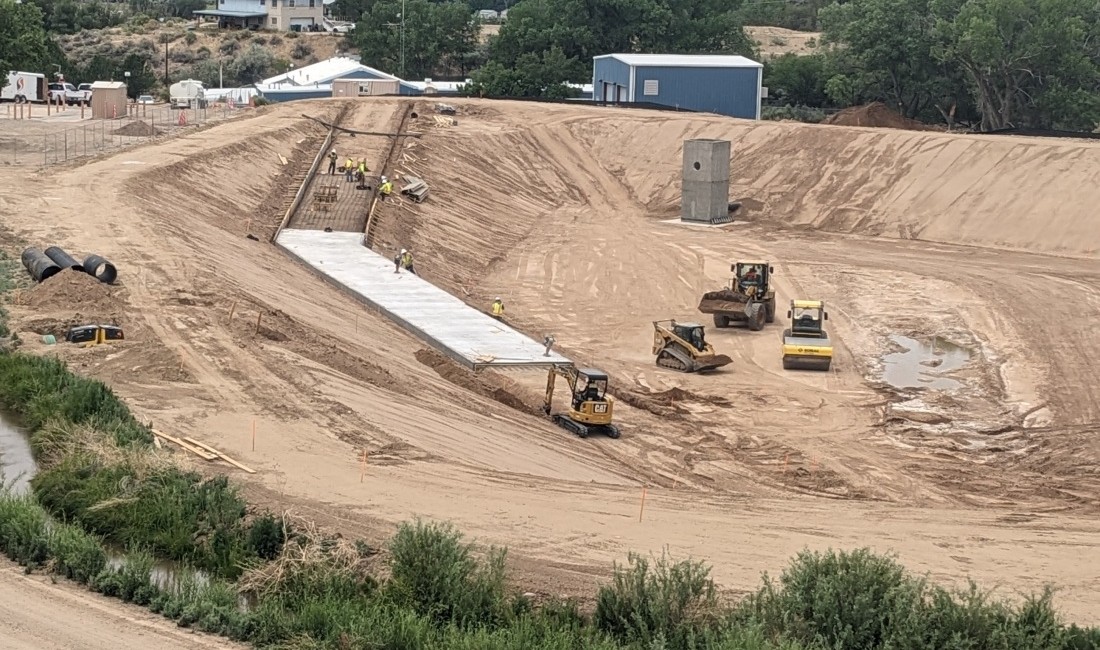

5/2/2024 |

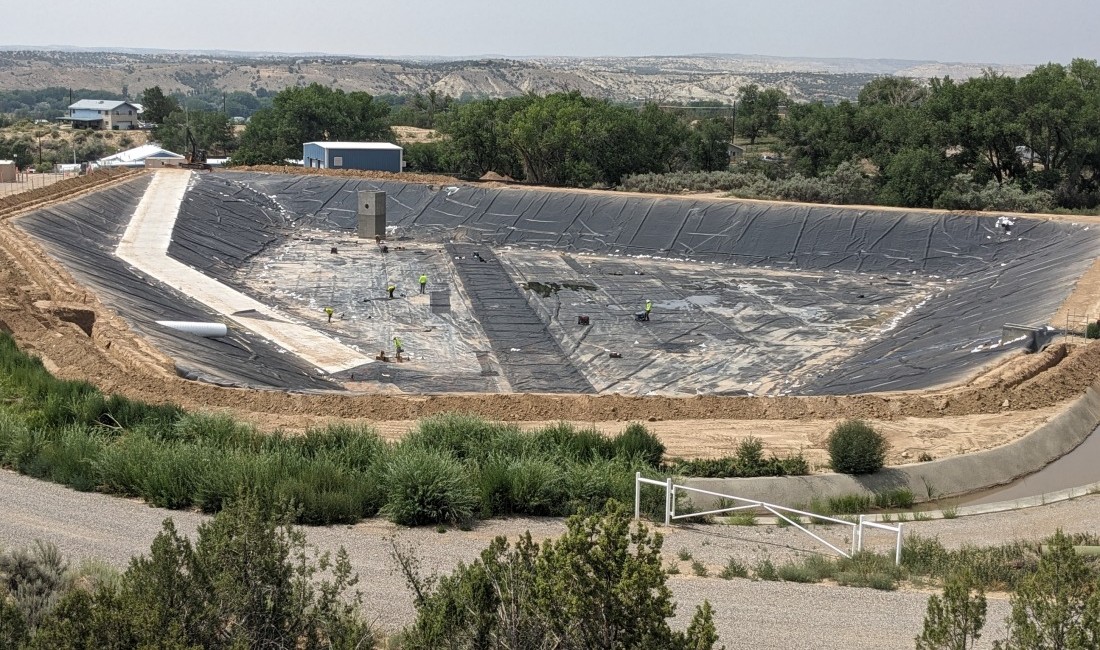

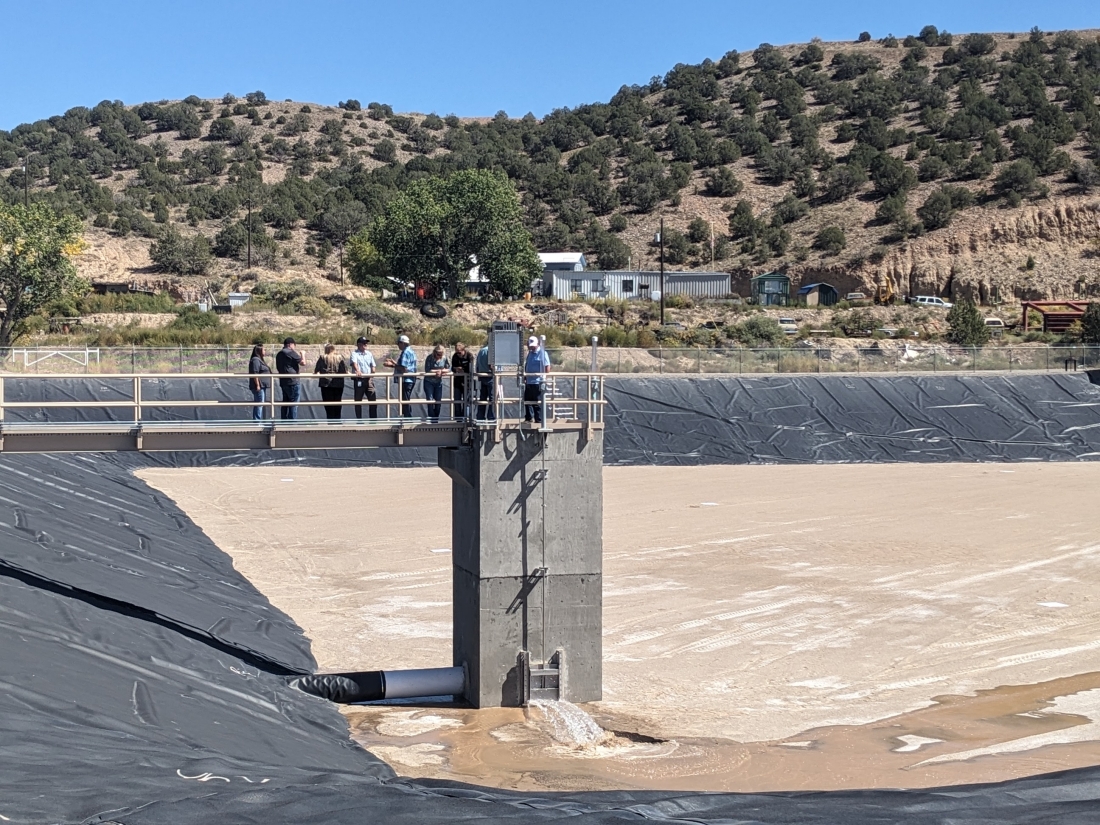

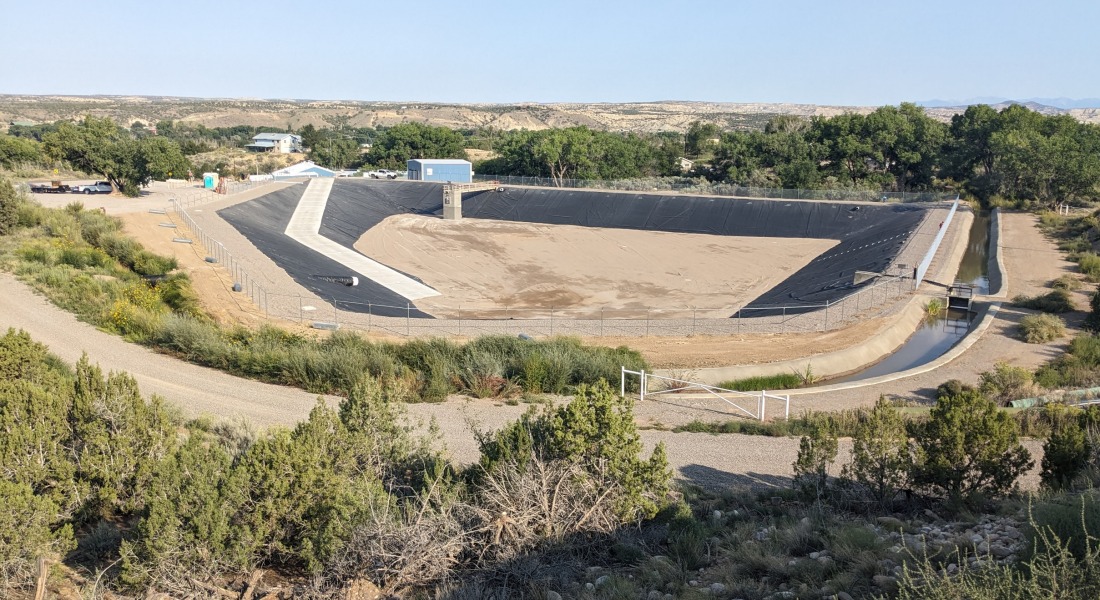

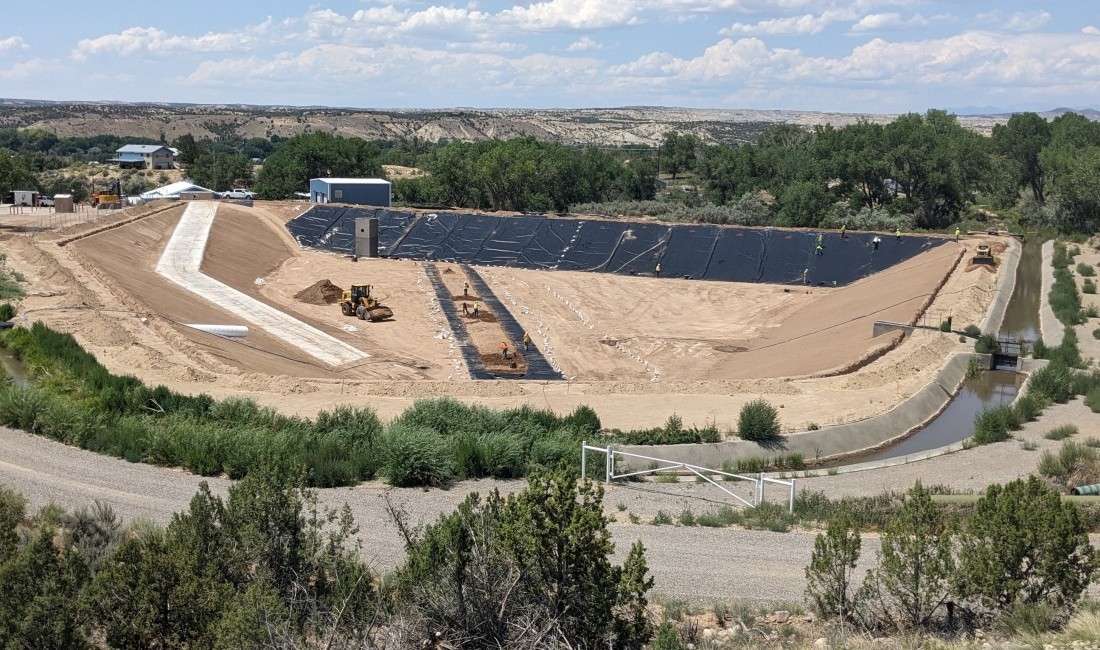

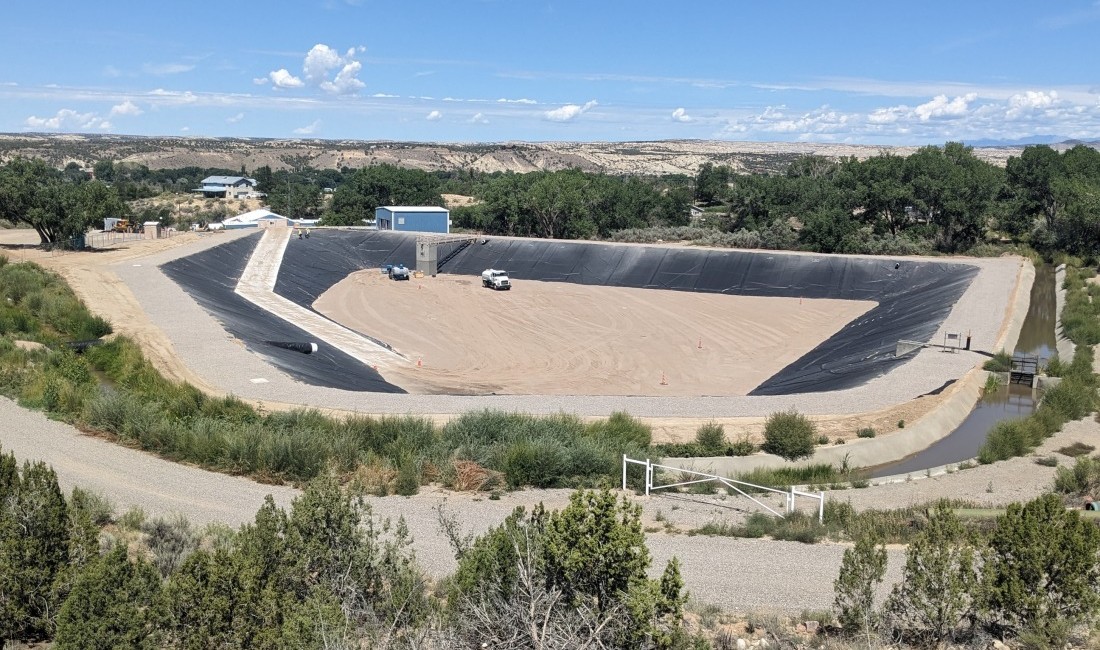

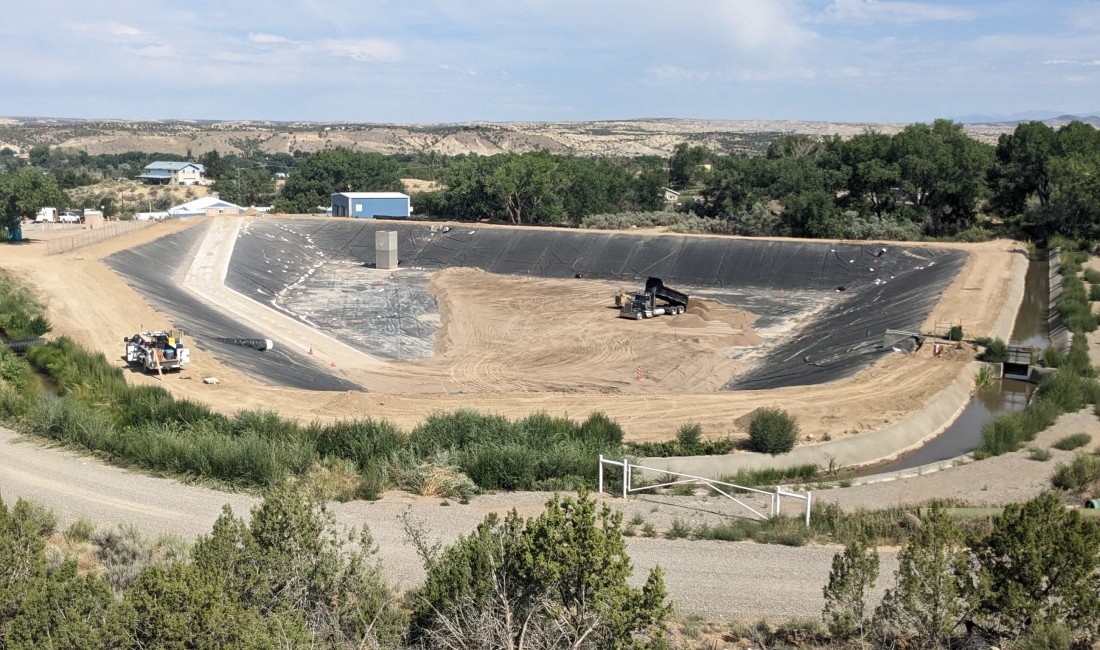

Dirt work and ramp construction underway. |
➠ Read More...
